Time in Status

Time and Story Points Estimation Using Pivot Table

šŸ“ Context: Estimating the development team’s efforts during a sprint is crucial for understanding productivity and workload distribution. Using the Time in Status app, you can analyze which developers closed the most story points and how much time each issue spent in progress.

šŸ¤” User Problem: Teams need a way to estimate the development team’s efforts during a sprint to understand productivity, identify bottlenecks, and make data-driven decisions.

Steps to configure:

  1. Open the Time in Status app.

  2. Select a Pivot Table view.

3. Choose the Time in Status report and the required Sprint.

TIS 2 (4).png

4. Then click the Field button.

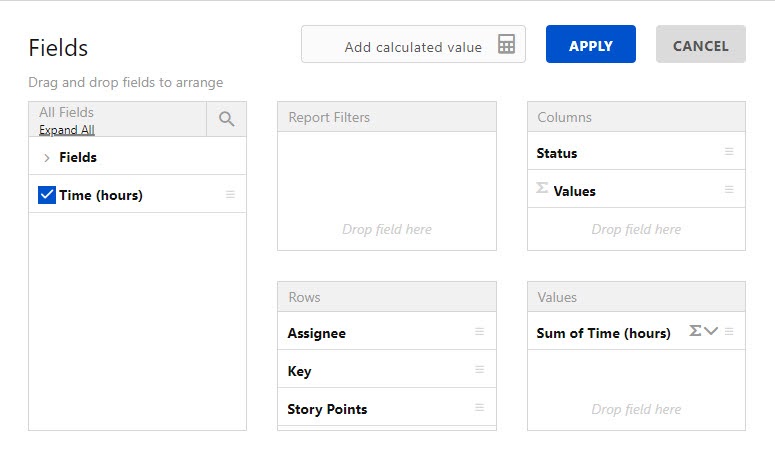

In the Field menu, you can customize data presentation by setting your custom fields for Rows, Columns, Values.

5. To get the time and story points, drag and drop such fields:

  • Assignee, Issue Key, and Story Points → Rows

  • Time (hours) → Values

  • Status → Columns

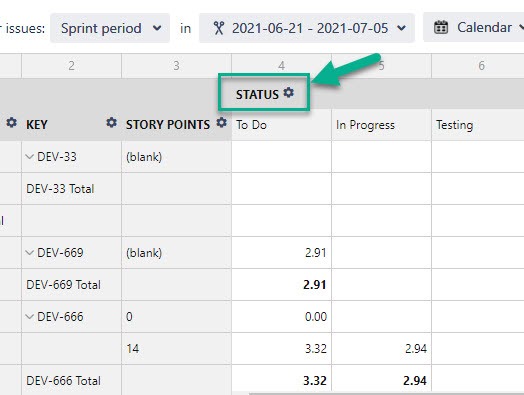

zAau5UuENtL0ON62jgvLr9Lo6WK6ybnq1ckgWnxLxIEOO_tGs_RSqTW3kV8TIIYNW-oUscM4iZBeWlFxCjycozR-xBu8a3ucXrB4ZSVHPXKxN7imSPRLldNc--CvJjERfb85B45M

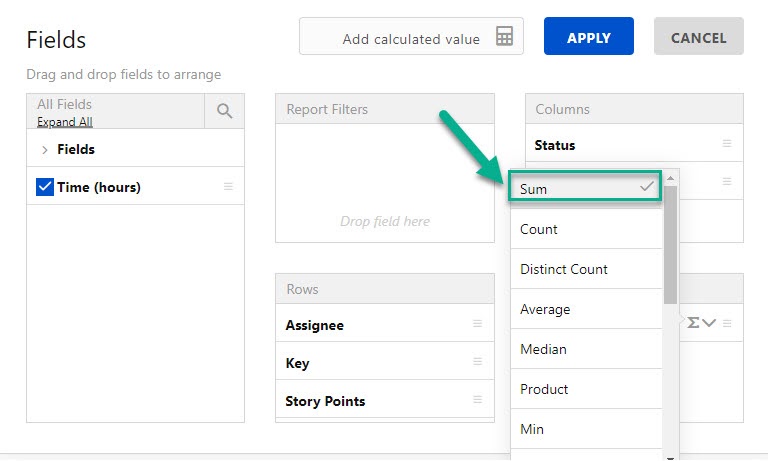

6. Select the Sum option in the Values drop-down menu.

5TuHEuGB0SexA5mPllD_hNXU4_RjiHvMeHzOUAuyKsJ0De0Y8hqg8L6xTMXpsVpFUvHgHqzk1aUcftJNXmq3uR4PiQTPsLr0_HCbQHTI3hHUFtAWPiVNZOJivuqVeYauf6uJ6-B7

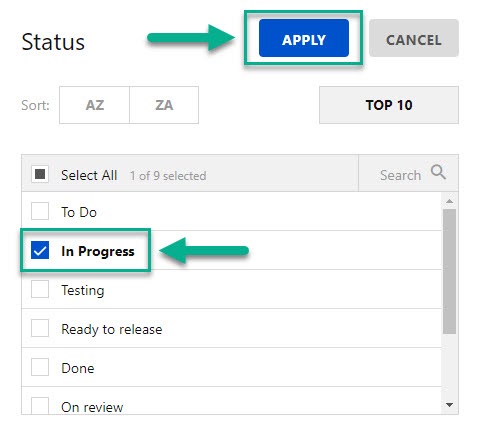

7. Click the gear to filter statuses when assignees are working on issues, according to your workflow, and apply it. Lets’ take ā€œIn Progressā€ as an example.

N2R9tByey51lfGjmdusxmO4tp9TJAEMmuaRF_RsMajPWKnDmjH7O2jrZzdX5lQ_sW8a918hJ_2s3MdsYYuUAegNVCllfoY8B3lb15WG25dT2pQgC0StgQ-NavCs9q4afx_t4HHHZ
FOM3213amNhkX6mzn3w_AnIYglKKuD7R_ObiqtWHnfXQxJcO5R5yi2nX9rE3UuBF2-I8wX6nCTVMffdxWEO7ENxZ22RFJkkrFOUpNx7qeDHDFeR9o9TrSRwz4l6EL41JcZw3ZwaR

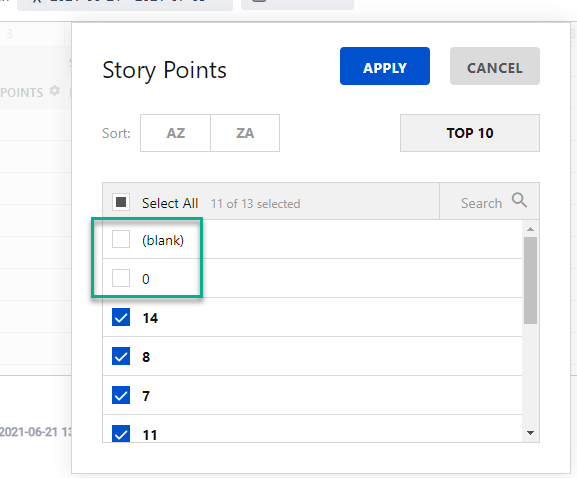

8. You can uncheck issues with blank and 0 estimations to get only the evaluated ones.

icaoJa0UiD9w4RnuXkD246ZdjFtqDwCxQ_dQjteNYlHGqb_jS5BxOKtedeEsNBx0vZAEelfkNq9OocTaArK9A0eWwjZV4V2QeTUeC0xMIpvUA_SOz8Rrxah5XDxO7PvJ-mNdaEBq

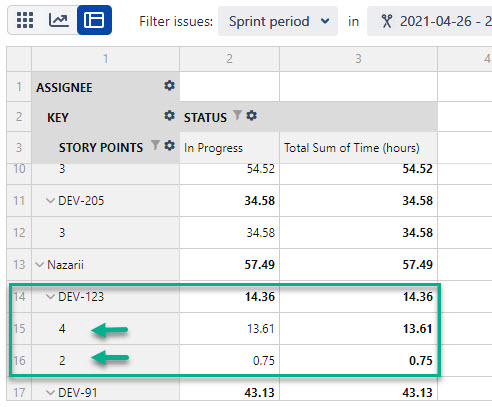

9. If an issue has been revalued, you will get the original estimation separately.

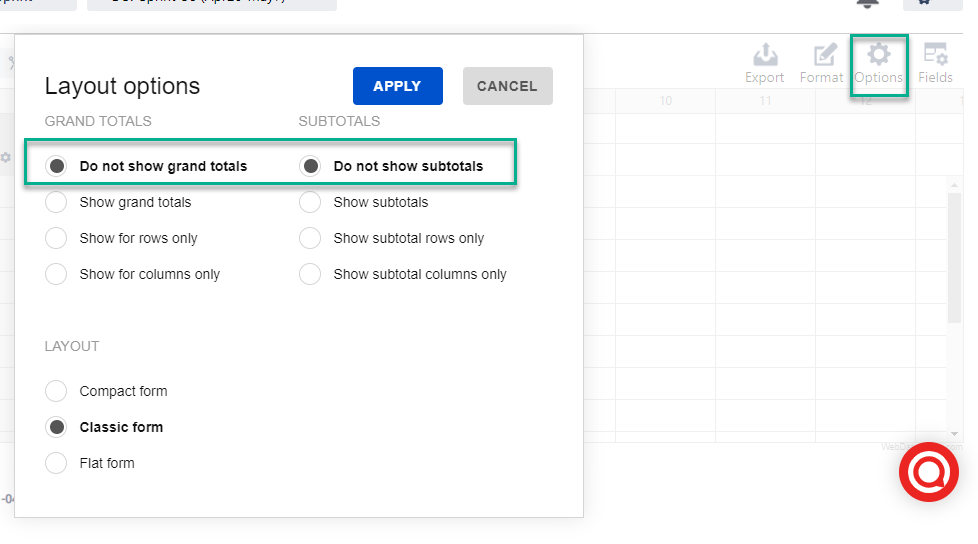

10. To move away total and subtotal values, go to the Options menu and apply:

  • Do not show grand totals ;

  • Do not show subtotals ;

  • Classic form ON.

cbMFr2wPRizjl2Xa1f7erSABmMaX_AyVyihKd0b4TpYL1i8tkMHHM-d7_CxsJG3k3wlBfmkEi_Hhv941wgYv2_1FfEUGp_DzjMDiVHhEDf0afU9rkzUh1vUyAA9Uqef01_4vnwEK

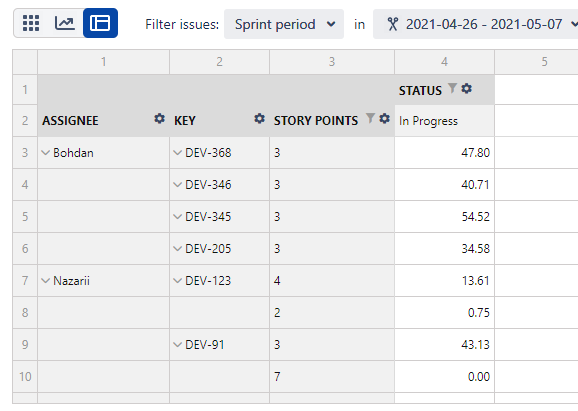

As a result, you will get the time in progress and story points for each assignee.

HXjqRfZdKEFE3bxiEid7lZzoLpFlbx-2bkJYsaJef1Mxr5hpd6hss6vTavNcvpM13m1Xrrb3dbmPqlfzrznEo3krySWsQNcbNqdbFGgSVwf3Qr5hPfpWSd9ozpTJPVJrKJi0Uofa

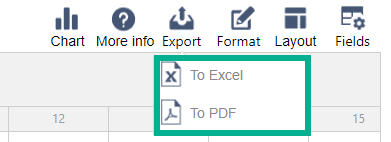

11. For further analysis, export the pivot table to Excel.

  • Remove the revalued estimate and leave the original one.

  • Sum up the story points and time for each assignee.

PcKWoPKisVK2_16HI_U2ppQwUOrMDdO7DBeTNY601xF4l0QE-Jhu5Lxrpr0K5ttKqKiVRWDuHU2v84up6aPdjvl4VOOwNBI4nMWpfiYzCsFoTHYrf5tY0m6cddDmH6WJaWsFRv7K

Now, you can compare how much time each team member has spent on issues and how many story points are closed.
